A team isn’t misaligned because it lacks a vision; it is misaligned because the cadence that surfaces disagreement before it hardens doesn’t exist.

Alignment is a meeting-design problem rather than a communication one, and the fix is a fixed review rhythm, not a better deck or a clearer slide.

What this unblocks:

A design team whose roadmap has quietly drifted from the company’s priorities, and a leader who only finds out when a decision lands that nobody in design saw coming.

What the output lets you do:

Run a review rhythm across three intervals that catches drift. At the same time, it is still a course correction, and trace every design objective to a business one a stakeholder outside design already recognises.

What you have at the end:

A weekly work review, a monthly metrics session, a quarterly objective reset, and a standing test for telling a design metric from a vanity one.

Where the objective-setting framework comes from

Objectives and Key Results (OKR) is the framework design teams most often borrow to make the trace from design work to business goals explicit. Andy Grove developed it at Intel in the early 1970s, building on Peter Drucker’s earlier management-by-objectives model and adding a measurable key result with a quarterly review cycle.

John Doerr learned the method from Grove at Intel and introduced it to Google’s founders in 1999, a year after the company’s founding. He later set out its full history in his 2018 book Measure What Matters.

The cadence this page describes borrows OKR’s discipline rather than its full apparatus: an objective states a direction, and its key results are numbers that already mattered to someone outside the team that set them.

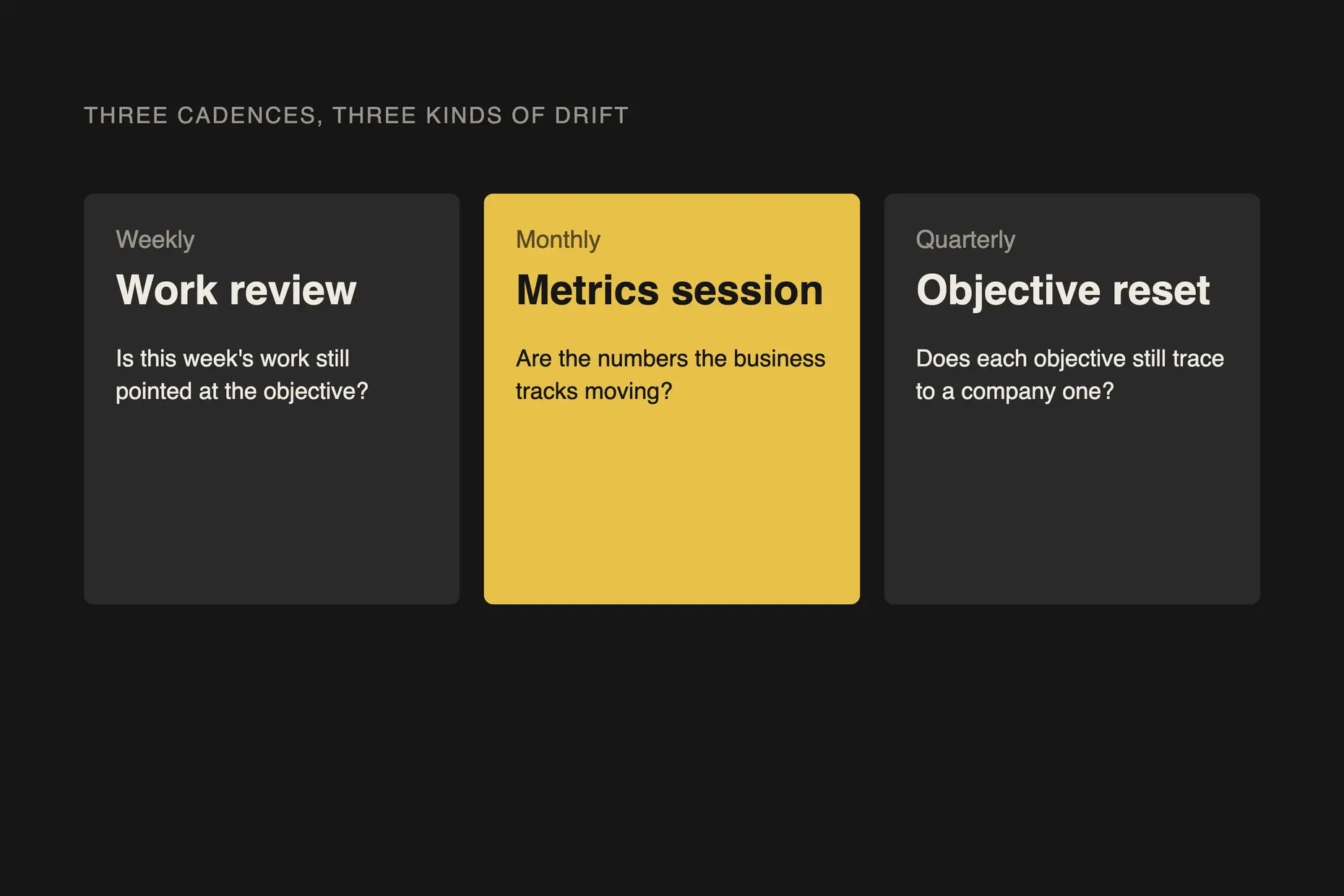

Three panels: a weekly work review, a monthly metrics session highlighted, and a quarterly objective reset
Three cadences, each catching a different kind of drift

How to implement it

Run three cadences at three different intervals. Each answers a different question and catches a different kind of drift.

CadenceQuestion it answersTypical formatWho attends
WeeklyIs this week’s work still pointed at the quarter’s objectives?Short team stand-up or work reviewThe design team and its lead
MonthlyAre our metrics moving, and do they still matter to the business?All-team session reviewing company and design metrics togetherThe whole design team, sometimes a business stakeholder
QuarterlyDo our objectives still serve the company’s, or has the company moved?Objective-setting or reset sessionDesign leadership and the function’s business sponsor

You must run the weekly review even when it feels disposable. It is the cheapest place to catch drift, and skipping it lets a week of misdirected work compound into a month of it.

You must trace every design objective to a company objective in one sentence. “Reduce onboarding drop-off” traces to a stated revenue or retention goal; “ship a new component library” does not, unless the sentence names the business outcome the library serves.

You must demonstrate impact on metrics the business already tracks: engagement, conversion, retention, and satisfaction, rather than a number design invented because no one else could check it.

When the company changes direction mid-quarter, you must re-plan the objective inside the next scheduled review rather than pausing the whole cadence. The cadence stays fixed; only the content reviewed inside it moves.

Silhouetted colleagues at a sunset window, one pointing at a large screen of charts
The monthly review: the team and the metrics owners watching the same numbers move

How to coach it

I do not hold this cadence for a lead forever. I set the rhythm and sit in the room for the first quarter, then hand the weekly and monthly reviews to the lead and keep only the quarterly reset, because that is the one where the company’s own goals are in the room and a lead newer to the business needs backing.

What I check without running it myself is whether the trace still holds: can the lead complete the sentence from a design objective to a business one without me prompting them? If they cannot, I do not write the sentence for them. I ask what the objective is protecting, and let the gap sit until they answer it themselves.

The conversation that goes wrong is when a monthly review turns into a status update: everyone reports what shipped, and nobody says what the numbers mean. When I catch that happening, I stop the meeting and ask one question instead: which of these numbers would worry us if it did not move next month? That question puts the metrics review back where it belongs.

I know a lead has got it when they cancel a piece of in-flight work themselves, in the room, before I would have raised it. A team that agrees on everything in a review has usually stopped arguing and started aligning; a team that still disagrees, but disagrees within the cadence rather than after a decision has already landed elsewhere, is the one that has got it.

A lead leaning over a desk, smiling as he talks a colleague through her notes
Hand over the weekly and monthly reviews; keep the check that the trace still holds

A worked example

At EY, the monthly metrics review was the cadence that did the most work. The design team and I sat in the same room as the company metrics leadership, who were already reporting on the same numbers, and watched them move together.

That review caught a drift the weekly stand-ups had missed: a design objective that had traced cleanly to a business goal three months earlier no longer did, because the business goal itself had moved. We rewrote the objective in the same session rather than waiting for the quarterly reset, and the team could see, in the room, why the old objective no longer earned its place.

Four people in silhouette against a bright window, one pointing at a whiteboard of notes
Rewriting the objective in the room, the moment the business goal moved

Where design team alignment fails

The clearest sign alignment has failed is when design hears about a strategic decision, a repositioning, or a cancelled initiative after it has already been made and communicated elsewhere. A genuinely aligned team sits close enough to the company’s decision-making cadence to be part of the conversation that produces the decision, not a downstream recipient of its outcome.

The cadence itself fails quietly before that, in three ways I have seen repeat:

  • It becomes a status meeting: people report what shipped, and nobody says what the numbers mean, so the review still happens but the checking has stopped.
  • Objectives get written to be achievable rather than useful, because an easy objective is safer to report against than a hard one that might miss.
  • Alignment gets declared from the top, in a deck or an all-hands, while the team privately disagrees and only says so outside the room.

None of these is fatal on its own. Left unaddressed, each arrives at the same place: a team that finds out last.

Common questions

How often should a design team check alignment with company goals:

Three cadences: weekly against the quarter’s objectives, monthly against company metrics, and quarterly to reset the objectives themselves. Skipping the weekly check lets drift compound before anyone notices it.

What is the difference between alignment and communication:

Communication states intent once, in a deck or a kickoff. Alignment is the repeated check that the intent still holds as both the team’s work and the company’s priorities move.

Are OKRs required for design team alignment:

No. OKR is one framework for tracing design objectives to business ones, and the discipline- an objective with a measurable result someone outside the team already cares about- matters more than the specific format.

How do you know if a design metric is a vanity metric:

Ask whether the business was already tracking the number before design did. One invented to describe only design’s own output is the vanity metric; one the business already reports on is not.

How do you tell a team that agrees from a team that has stopped arguing:

A team that agrees on everything in a review has usually stopped bringing disagreement into the room. A team that still disagrees, but disagrees inside the cadence rather than after a decision has landed elsewhere, is the one that has aligned.

Key facts, current as of September 2026

FactDetail
Framework most often borrowedObjectives and Key Results (OKR)
OKR originatorAndy Grove, at Intel, early 1970s, building on Peter Drucker’s management-by-objectives model
OKR popularisedJohn Doerr, introduced the method to Google’s founders in 1999
OKR’s full historyMeasure What Matters, John Doerr, 2018
Review cadencesWeekly work review, monthly metrics review, quarterly objective reset
Clearest failure signalDesign learns of a strategic decision after it has been made and communicated elsewhere
